Report № 01 Nuda Skin Lab · Berawa 20 May 2026
Nuda Skin Lab · fit-out on site
Progress Documentation · № 01 · Weeks 1–2

Nuda
Skin Lab.

Two weeks on site — partitions framed, MEP first-fix complete, ceilings framed and floors prepared. The clinic stands at mid-build.

Owner PT Nuda Skin Lab
Main Contractor Constructland Indonesia
Location Berawa, Canggu
Period 6 — 20 May 2026

Two weeks in, mid-build.

17fronts

MEP first-fix is complete, partition framing stands across all eight rooms, ceilings are framed and floors are prepared for tiling. Two weeks in, the clinic has reached mid-build — its structural and services backbone fully in place.

Ahead of the ten-week plan.

Phase schedule · planned window & completion to date
I · MobilisationSet-out · Demolition
Complete
II · Partitions & MEPFraming · First-fix MEP
Complete
III · Ceilings & FloorsLinings · Wet-trades · Flooring
In progress
IV · FinishesWall finishes · Second-fix
Upcoming
V · Joinery & HandoverFurniture · Signage
Upcoming
W1 W2 W3 W4 W5 W6 W7 W8 W9 W10
Long-lead procurement · to order now

Four packages carry supplier lead times longer than the trades that install them. The floor screed is already prepared and waiting on tile. Placing these orders now is what keeps Phases III–IV on the ten-week programme.

  • Multi-zone split AC system 7 units · long lead
  • Sensor glass main entrance Custom · long lead
  • Granite tile flooring ≈ 87 m² · bulk order
  • Acoustic wall insulation CO-01 · fit before boarding closes

The work, by trade.

A
Partition FramingLightsteel stud frame · all eight rooms
Complete
B
MEP First-FixConduit · wiring · piping · back-boxes · distribution board
Complete
C
Ceiling FramingGalvalum frame · ready for boarding
Complete
D
Floor PreparationScreed & embedded services · ready for tiling
Complete
E
Calciboard BoardingWall & ceiling linings · reception · corridor
In progress
F
Data & ConnectivityBusiness-grade router · reception
Complete

What got built.

W1–2
Reporting period6 — 20 May 2026
  • Lightsteel partition framing erected across all eight clinic rooms
  • Calciboard boarding installed to partition walls and the corridor

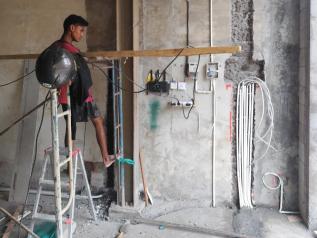

  • MEP first-fix completed — conduit, wiring and piping run throughout
  • Electrical distribution board mounted and wired at reception

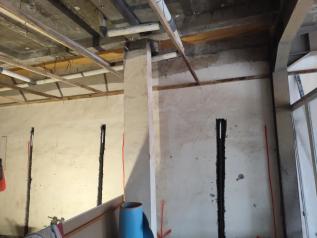

  • Wall and floor chases cut; back-boxes set for sockets and switches

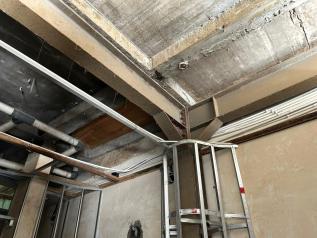

  • Ceiling framing installed clinic-wide, ready for boarding

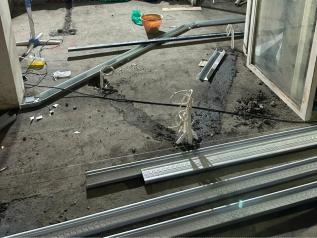

  • Floor screed and embedded services finished — ready for tiling
  • Business-grade router supplied and installed at reception
17
Work fronts documented
5
Trades complete
8
Rooms framed

Partition framing

All eight rooms · complete

Ceilings & floor

Framed & prepared · ready for finishes

Calciboard boarding

Walls & corridor · in progress

MEP first-fix

Clinic-wide · complete
Approved by
Ragnar KenkConstruction Director
Checked by
GigiSite Documentation
